Skip to main content
District

Capital Project

On Oct. 18, 2022 voters in the South Colonie Central School District approved two capital project propositions that together will result in more than $120 million in improvements across the district.

This update for the Next Generation Capital Project highlights significant improvements at Colonie Central High School, including the installation of a new turf field and scoreboard. Future upgrades will include a resurfaced gym floor, a modern concession area, an upgraded press box and grandstand, and a new athletic center with updated team and locker rooms. These enhancements aim to provide top-quality facilities for students and the community, supporting the school's ongoing commitment to excellence.

Capital Project Spotlight

auditorium

Lisha Kill Auditorium Renovation Update

Renovations are currently underway at the Lisha Kill Auditorium, with plans to significantly enhance the facility. The updates will include improvements to stage rigging, lighting, and sound systems to create a more dynamic performance space. These upgrades are designed to provide students and the community with a modern, state-of-the-art venue for performances and events.

Colonie

Colonie Turf Field ready for play

The new Colonie turf field is ready for play, marking a major Next Generation Capital Project milestone. While work is still ongoing on the press box, concession stands, and other amenities, our teams are excited to hit the field and show their Wolf Pack spirit. This state-of-the-art facility represents a new era for Colonie athletics.

aerial

Sand Creek parking lot and stormwater work complete

The resurfacing of the parking lot and sidewalks at Sand Creek Middle School has been successfully completed as part of our regular maintenance. In addition, stormwater management improvements near the tennis courts, conducted under the Next Generation Capital Project, have been finished. While these updates briefly limited parking access over the summer, the enhancements will provide long-term benefits for the campus.

aerial

Shaker Road Elementary New Bus Loop Completed

We are excited to announce that the new bus loop and parking lot at Shaker Road Elementary School are officially open! We appreciate your patience and cooperation during the transition period as everyone gets accustomed to the new traffic pattern. Thank you for helping us make this a smoother and safer experience for all!

Next Generation Colonie

Proposition #1

Proposition #1 includes a $112.5 million dollar capital project referendum to address aging infrastructure, improve instructional spaces, and provide essential safety upgrades districtwide. Project to include instructional space enhancements including auditoriums and athletics, a new transportation facility, and district office expansion to meet current operating needs. South Colonie community supported this proposition Yes – 1151 / No – 408  (74% in favor).

Proposition #2

Proposition 2 includes a $7.5 million dollar debt neutral proposition for the South Colonie to receive an additional 10% building aid on an energy performance contract (EPC) to improve energy efficiencies in all buildings. The cost of the EPC is offset in energy saving costs and would have no additional tax impact to residents. South Colonie community supported this proposition Yes – 1234/ No –  323  (79% in favor).

Stage I

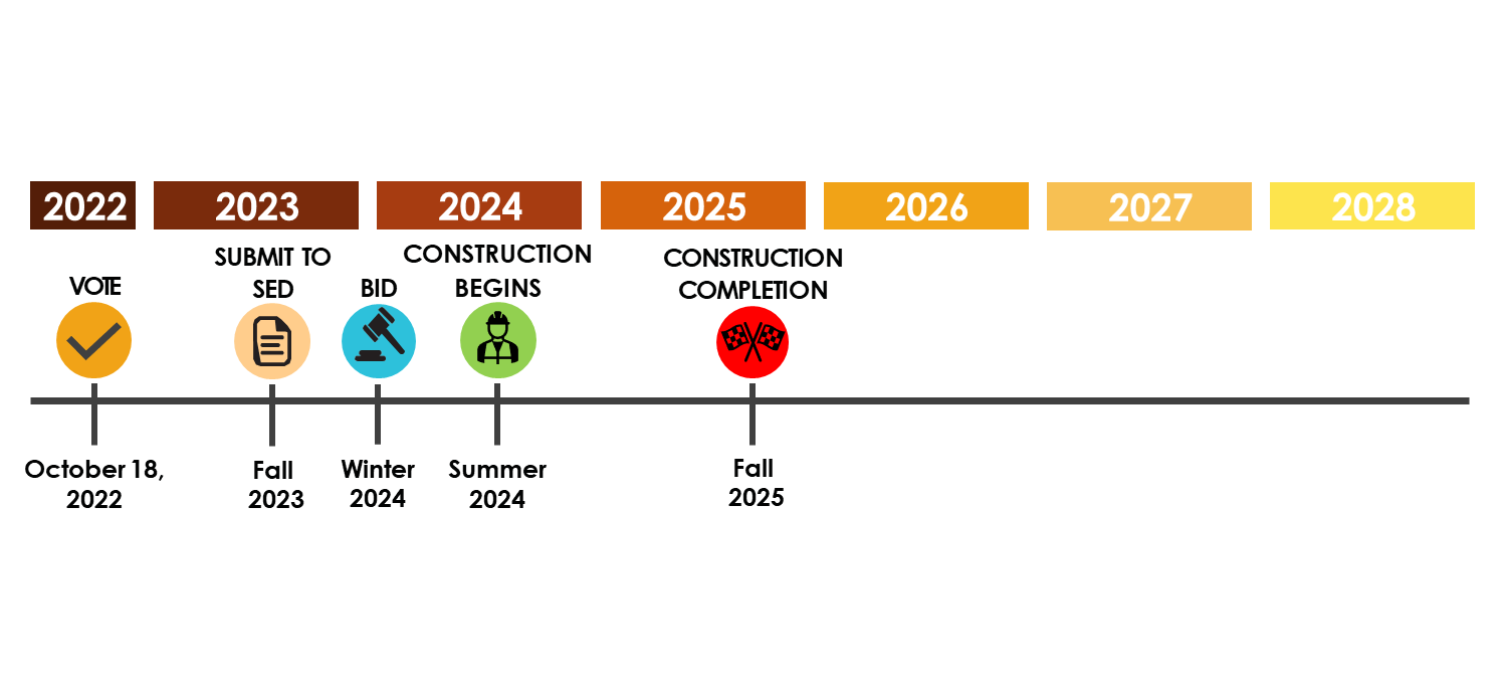

Construction Stage I Timeline

Since voter approval, Board of Education members and district leadership have been working collaboratively to engage stakeholders on the first stage designs. The design work for Stage I of the project has been submitted to the New York State Education Department (NYSED) for approval with construction plans set to begin on South Colonie campuses as early as Spring 2024.

  • Turf Field Rendering
    Turf Field Rendering
  • New concession pavilion with toilet facilities and grand entry.
    New concession pavilion with toilet facilities and grand entry.
  • Shaker Road Bus Loop
    Shaker Road Bus Loop
  • Lisha Kill Auditorium Design Mockup
    Lisha Kill Auditorium Design Mockup
  • Lisha Kill Front Facade
    Lisha Kill Front Facade
  • High School Classroom Sample
    High School Classroom Sample

Click on the school below to see constrution timeline for each school

  • Scheduled to begin April ‘24

    • New Synthetic Turf Multi-Purpose Field
    • New Home Side Bleachers w/ dual purpose press box
    • New Concession Pavilion w/ toilet facilities and grand entrance
    • New Lighting on main field and replacement lamps on soccer field
    • New discus area, shot putt areas, long jump areas

    Scheduled to begin May ‘24

    New Integrated FA/PA System

    Scheduled to begin June ‘24

    • New entry floor and floor finish in MUG corridor to ‘G’ Wing
    • Renovated and enlarged athletic trainer suite & new gender-neutral bathroom(s)
    • Renovated basement team / locker rooms, Pit locker rooms
    • Renovation of wing B Classrooms and creation of AIS rooms
    • Replacement of building envelope with curtain wall system & new UV’s in classrooms with futureproofing for possible AC.
    • Renovations to library support spaces
    • Replacement of select exterior doors and improvements to door access control
    • Mechanical upgrades including add alternates for AC in classrooms
    • Roof reconstruction at the MUG, Pit Gym and Math Wing

    Scheduled to begin June ‘25

    • Renovation of ‘F’ wing classrooms
    • ‘F’ wing windows/Façade work

  • Scheduled to begin May ‘24

    New Integrated FA/PA System

    Scheduled to begin June ‘24

    • Roof Replacement
    • Stormwater Detention System Replacement

  • Scheduled to begin June ‘24

    • Reconstruction of sidewalks and ADA entrances
    • Select exterior door replacement

    Scheduled to begin June ‘25

    Roof Replacement at Gym

  • Scheduled to begin June ‘24

    • Replacement of exterior storefront/Window system
    • Select exterior door replacement

    Scheduled to begin June ‘25

    Roof Replacement at Gym

  • Scheduled to begin June ‘24

    • Reconstruction of bus loop, staff and visitor parking, hardcourt  play area, emergency access road and sidewalks
    • Removal of Old lift pumps and sanitary / storm tanks

    Scheduled to begin July ‘24

    Removal of wooden play structures and reinstatement of grass

    Scheduled to begin April ‘25

    • Renovation of six classrooms into model 21st century learning  environments
    • Renovation to main office and nurse suite

    Scheduled to begin June ‘25

    • Replacement of exterior storefront system
    • Select exterior door replacement
    • Roof replacement at Gym

  • Scheduled to begin June ‘25

    • Resurface Tennis Courts and New Backboards
    • Replacement of building envelope with curtain wall system & new UV’s in classrooms with futureproofing for AC.
    • Renovation of Auditorium to include stage rigging, lighting, sound, acoustic control, house finishes

  • Scheduled to begin Summer/Fall ‘25

    • Electric Infrastructure Work
    • Gas Line Re-Routing
    • Demolition of Buildings B, C, and D and Site Stabilization

Stage II

Stage II Timeline

Stage III

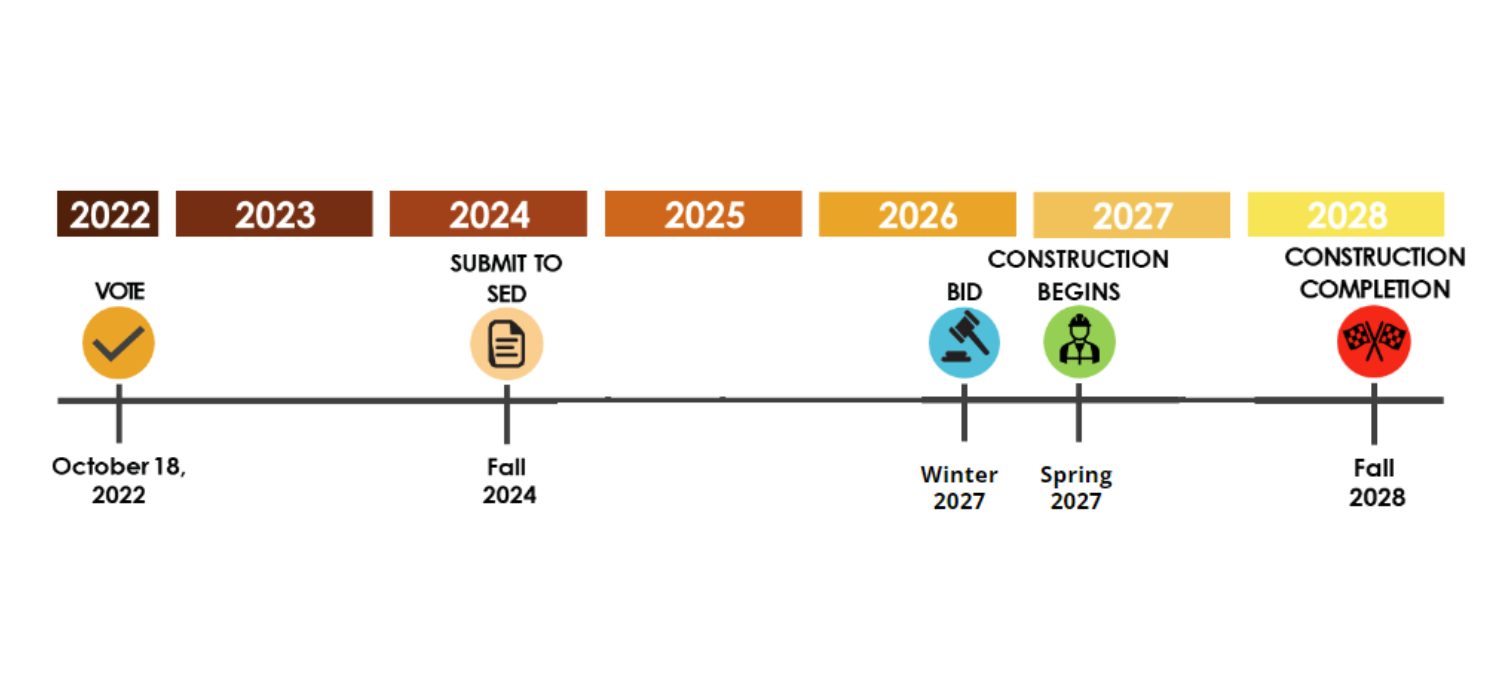

Construction Stage III Timeline

Building History

Click Building History to review South Colonie’s building history

  • Colonie Central High School

    • 1952, built
    • 1989, MUG gym addition
    • 2000, New math wing  added (10 classes)

    Sand Creek Middle School

    • 1968, built
    • 2000, new classrooms/gold gym

    Lisha Kill Middle School

    • 1958, built
    • 2000, New classrooms
    • 2006, New tech rooms

    Roessleville Elementary

    • 1972, built
    • 2018, new library

    Forest Park Elementary

    • 1966, built
    • 2000, new classrooms
    • 2018 new library

    Shaker Road Elementary

    • 1958, built
    • 2000, new classrooms
    • 2006, new library

    Saddlewood Elementary

    • 1958, built
    • 2000, new classrooms
    • 2006, new library

    Veeder Elementary

    • 1966, built
    • 2000, new classrooms
    • 2006, cafeteria expansion, new small gym

    Bus Garage

    • 1948, built
    • 1957, added bus barn
    • 1991,  added office area and driver room updates
    • 1998, built a two bay garage building in 1998 after NYSDOT deemed current
    • garage unsafe

    District Office

    • 1971, built (intended to be a temporary 20 year location)

Project Overview

Click on the location below to see planned work

    • Auditorium renovations – Front of house improvements
    • Library Media Center renovations – ARPA federal funds
    • Classroom renovations (290’s, 110’s, 210’s)
    • Locker room renovations
    • Restroom renovations
    • Upgraded fitness center
    • Replace fire alarm system with combined FA/PA

    • Site roadway enhancements – Drop off lane and front sidewalk reconstruction
    • Resurface outdoor playcourts and provide new backboards
    • Auditorium renovation
    • Locker room and team room enhancements
    • New exterior walls/facade on the original portion of the building
    • Upgraded nurses’ office suite and restrooms near the auditorium
    • Restroom renovations
    • Classroom renovations
    • Internal cosmetic changes (upgrades to the wood paneling)
    • Replace fire alarm system with combined FA/PA

    • Auditorium renovation
    • Classroom renovations
    • Locker rooms and adjacent bathrooms enhancements
    • Fitness center enhancements
    • Music area enhancements
    • Restroom renovations
    • Updated nurses’ office suite
    • Replace fire alarm system with combined FA/PA

    • Synthetic turf multi-use athletic field (Ambrosio stadium field) Field Complex with concession upgrades and bathroom facilities
    • High school fitness center upgrades
    • New Team Rooms
    • Refinish MUG Gymnasium Wood Floor

    • Transportation, O&M facility to support a fleet of 75 buses and 150 employees
    • Enhancements and expansion to South Colonie District Offices to meet current needs

    • Playground improvements at all elementary schools
    • NEW Library Media Center at Veeder Elementary
    • Classroom renovations
    • Nurses office remodels
    • Restroom renovations/upgrades
    • New bus loop at Shaker Road
    • Window and HVAC upgrades as needed

  • Technology

    • Additional security cameras districtwide
    • Secure card access entry points at all buildings
    • Technology infrastructure upgrades

    Other

    • Roofing Replacements at CCHS, Roessleville, Shaker Road, Sand Creek, Veeder, Forest Park and Saddlewood
    • HVAC improvements at CCHS, Shaker Road, Sand Creek, Veeder, Lisha Kill, Forest Park, Saddlewood and Roessleville

Project Videos

Next Generation Colonie 2025

New Transportation Facility to support growing fleet
